Wellington Pump Station Upgrade Project

Future Wellington Pump Station Model

The Regional District of Nanaimo (RDN) is upgrading the Wellington Pump Station to:

  • Increase capacity by approximately 40 per cent to meet future growth in the City of Nanaimo.
  • Increase the reliability of the station by replacing aged infrastructure and adding stand-by power.
  • Improve safety for RDN workers by eliminating confined spaces, and improving ventilation and lighting.
  • Reduce nuisance odours.
  • Improve beach access for City of Nanaimo residents.
  • Respect archaeological values.
  • Protect the environment.

The Wellington Pump Station, located at 5200 Fillinger Crescent in Nanaimo, was built in 1978. The pump station currently conveys approximately 25 per cent of the City of Nanaimo wastewater flows to the Greater Nanaimo Pollution Control Centre.

The viewing platform and beach access will not be available to the public during construction. Initial site works will begin in the summer of 2024 and are expected to be complete in the Winter of 2026.

How you can get involved:

  • Subscribe to stay informed on this project. Subscribers will receive occasional emails with project updates.
  • Explore this webpage to find out more.

The Regional District of Nanaimo (RDN) is upgrading the Wellington Pump Station to:

  • Increase capacity by approximately 40 per cent to meet future growth in the City of Nanaimo.
  • Increase the reliability of the station by replacing aged infrastructure and adding stand-by power.
  • Improve safety for RDN workers by eliminating confined spaces, and improving ventilation and lighting.
  • Reduce nuisance odours.
  • Improve beach access for City of Nanaimo residents.
  • Respect archaeological values.
  • Protect the environment.

The Wellington Pump Station, located at 5200 Fillinger Crescent in Nanaimo, was built in 1978. The pump station currently conveys approximately 25 per cent of the City of Nanaimo wastewater flows to the Greater Nanaimo Pollution Control Centre.

The viewing platform and beach access will not be available to the public during construction. Initial site works will begin in the summer of 2024 and are expected to be complete in the Winter of 2026.

How you can get involved:

  • Subscribe to stay informed on this project. Subscribers will receive occasional emails with project updates.
  • Explore this webpage to find out more.
  • Potential Noise and Odour - Phase 3 Start

    On October 29th, the Wellington Pump Station Upgrade Project completed Phase 2 and connected its new electrical building to the BC Hydro power grid. This milestone allows the project to move to the third and final phase of the project. For this phase, wastewater will be diverted around the pump station so the piping, electrical, and mechanical equipment inside the station can be replaced or refurbished.

    Timing of the Work:

    • The work will begin on November 12th and be completed in the Spring of 2027.

    What to Expect:

    • RDN’s contractor will be on site nearly 24/7.
    • Areas will be fenced off for public safety.
    • Construction noise will occur within regular work hours of 7 am – 6 pm on Monday to Friday, and 9 am – 5 pm on Saturday and Sunday.
    • The diversion pumps will be powered electrically, which eliminates the need for loud diesel generators that run constantly.
    • The backup generator will power the pumps only if a power outage occurs and will produce noise.
    • Temporary odours may be experienced. A new odour control unit is expected to reduce odours upon project completion.


    On October 29th, the Wellington Pump Station Upgrade Project completed Phase 2 and connected its new electrical building to the BC Hydro power grid. This milestone allows the project to move to the third and final phase of the project. For this phase, wastewater will be diverted around the pump station so the piping, electrical, and mechanical equipment inside the station can be replaced or refurbished.

    Timing of the Work:

    • The work will begin on November 12th and be completed in the Spring of 2027.

    What to Expect:

    • RDN’s contractor will be on site nearly 24/7.
    • Areas will be fenced off for public safety.
    • Construction noise will occur within regular work hours of 7 am – 6 pm on Monday to Friday, and 9 am – 5 pm on Saturday and Sunday.
    • The diversion pumps will be powered electrically, which eliminates the need for loud diesel generators that run constantly.
    • The backup generator will power the pumps only if a power outage occurs and will produce noise.
    • Temporary odours may be experienced. A new odour control unit is expected to reduce odours upon project completion.


  • November 9, 2026 Generator Commissioning

    As part of the ongoing Wellington Pump Station Upgrade, a new backup generator will be commissioned to provide back-up power to the station. This will include running the generator to ensure its function and the control systems for it.

    We are posting this notice to advise neighbours of anticipated noise during this commissioning.

    The original notice period was for Oct 26-30 but did not take place during that time. This notice has been updated to reflect the new commissioning date.

    Running the generator will produce a level of noise that will be audible to residents who live close to the station along Fillinger Crescent and Entwhistle Drive. The noise will be most noticeable to residents who are directly adjacent to the station.

    • Start-up activities will take place on Nov 9th and 10th, 2026
    • The generator will be run continuously for approximately 6hrs on Nov 10th, 2026 to prove its functionality and reliability
    • The generator will only be started between 8:30 a.m.-5 p.m. except in the occurrence of an unrelated power outage to the area

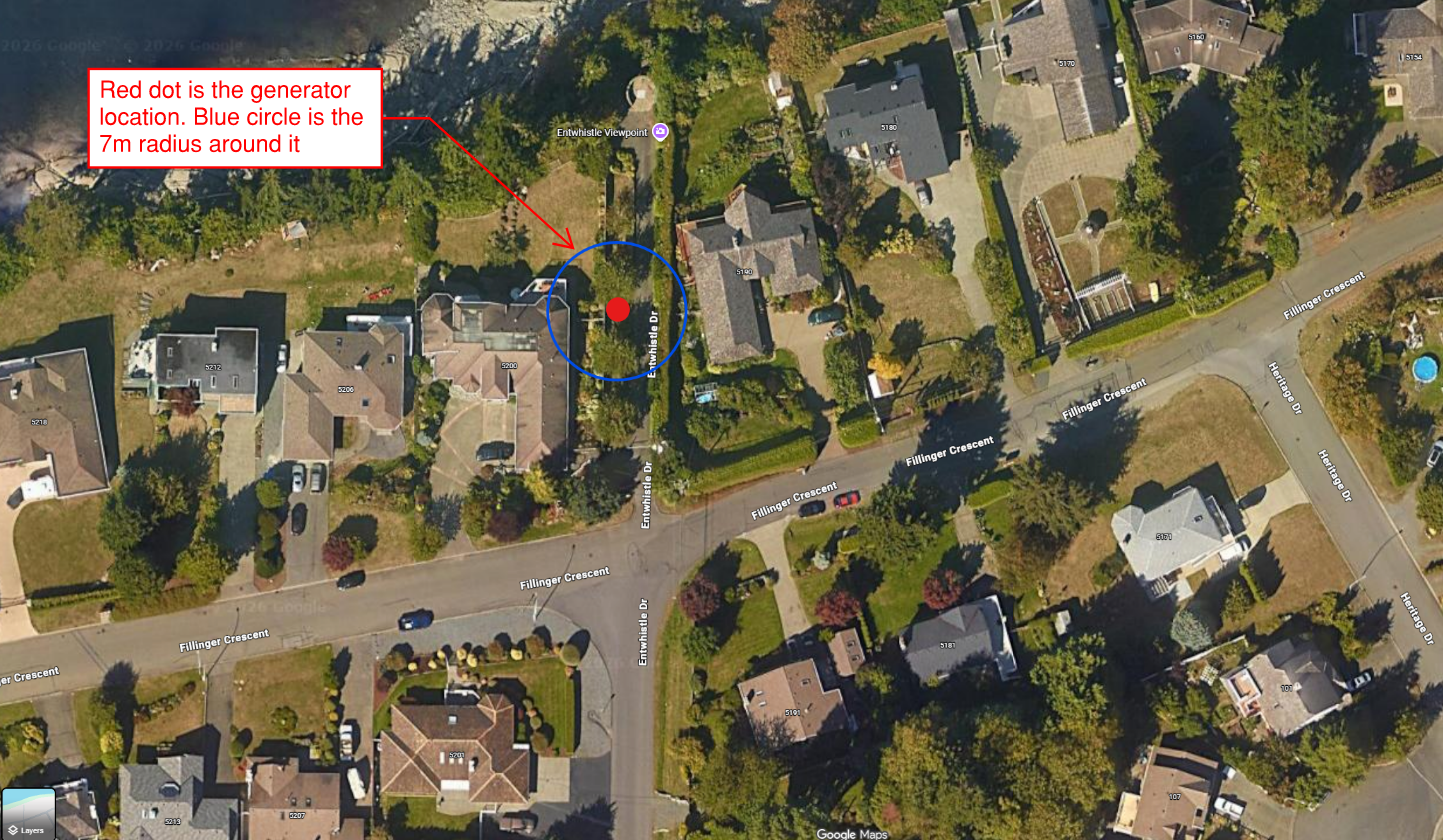

    • The sound level at the blue circle in the attached map will be similar to hearing a next-door neighbour use a gas-powered lawn mower while you are outside
    • Noise levels will decrease as the distance to the generator increases. People in houses across the street and further along the road will experience noise similar to a neighbour 5-6 houses away using a gas-powered lawn mower

    As part of the ongoing Wellington Pump Station Upgrade, a new backup generator will be commissioned to provide back-up power to the station. This will include running the generator to ensure its function and the control systems for it.

    We are posting this notice to advise neighbours of anticipated noise during this commissioning.

    The original notice period was for Oct 26-30 but did not take place during that time. This notice has been updated to reflect the new commissioning date.

    Running the generator will produce a level of noise that will be audible to residents who live close to the station along Fillinger Crescent and Entwhistle Drive. The noise will be most noticeable to residents who are directly adjacent to the station.

    • Start-up activities will take place on Nov 9th and 10th, 2026
    • The generator will be run continuously for approximately 6hrs on Nov 10th, 2026 to prove its functionality and reliability
    • The generator will only be started between 8:30 a.m.-5 p.m. except in the occurrence of an unrelated power outage to the area
    • The sound level at the blue circle in the attached map will be similar to hearing a next-door neighbour use a gas-powered lawn mower while you are outside
    • Noise levels will decrease as the distance to the generator increases. People in houses across the street and further along the road will experience noise similar to a neighbour 5-6 houses away using a gas-powered lawn mower
  • April 14, 2026 Update

    The final phase of construction, Phase 3, has been awarded for construction. Below are some schedule and progress notes:

    • March to July, 2026: Exterior grading, construction of new control building and emergency generator pad
      • Fun Facts:
        • The new control building is required to safely accommodate the electrical equipment required to support population growth and the capacity upgrade of the pump station.
        • The new control building will also house a new odour control unit, which will reduce the odour generated by the pump station.
        • The emergency generator is required to ensure that sewage keeps moving in the system during extended power outages.
      • What to expect: Construction noise, dust during dry weather excavation work, occasional traffic stops to allow equipment to move on/off site, and construction traffic.
    • May 2026: Preparation of main pumpstation structure for internal refurbishment.
      • What to expect: Noise from concrete cutting and modification work.
    • July 2026: Commissioning of new control building.
      • What to expect: Noise during testing of new generator and control room equipment, possibility of localized odour during startup and testing of the new odour control system.
    • June to November, 2026: Operation of a new and temporary pumping system to have the sewer flow bypass the existing pump station structure, allowing it to be refurbished and upgraded on the inside.
      • Fun Facts:
        • Temporary bypass pumping is essential to be able to access the interior of the pump station and refurbish it.
        • The temporary bypass pumping must be done during the summer while flows are lowest.
        • The system has been designed to be powered from the new control building, avoiding the need for loud diesel generators to power the pumps.
      • What to expect: Noise from the operation of pumps, which will start and stop as flows demand. Potential for localized odours as the temporary pumping system cannot provide a seal as effective as the pump station structure.
    • June to November, 2026: Interior refurbishment and upgrade of the existing pump station structure.
      • What to expect: Noise from construction works, construction traffic.
    • December 2026: Construction complete, public access reinstated.

    The final phase of construction, Phase 3, has been awarded for construction. Below are some schedule and progress notes:

    • March to July, 2026: Exterior grading, construction of new control building and emergency generator pad
      • Fun Facts:
        • The new control building is required to safely accommodate the electrical equipment required to support population growth and the capacity upgrade of the pump station.
        • The new control building will also house a new odour control unit, which will reduce the odour generated by the pump station.
        • The emergency generator is required to ensure that sewage keeps moving in the system during extended power outages.
      • What to expect: Construction noise, dust during dry weather excavation work, occasional traffic stops to allow equipment to move on/off site, and construction traffic.
    • May 2026: Preparation of main pumpstation structure for internal refurbishment.
      • What to expect: Noise from concrete cutting and modification work.
    • July 2026: Commissioning of new control building.
      • What to expect: Noise during testing of new generator and control room equipment, possibility of localized odour during startup and testing of the new odour control system.
    • June to November, 2026: Operation of a new and temporary pumping system to have the sewer flow bypass the existing pump station structure, allowing it to be refurbished and upgraded on the inside.
      • Fun Facts:
        • Temporary bypass pumping is essential to be able to access the interior of the pump station and refurbish it.
        • The temporary bypass pumping must be done during the summer while flows are lowest.
        • The system has been designed to be powered from the new control building, avoiding the need for loud diesel generators to power the pumps.
      • What to expect: Noise from the operation of pumps, which will start and stop as flows demand. Potential for localized odours as the temporary pumping system cannot provide a seal as effective as the pump station structure.
    • June to November, 2026: Interior refurbishment and upgrade of the existing pump station structure.
      • What to expect: Noise from construction works, construction traffic.
    • December 2026: Construction complete, public access reinstated.
  • October 24, 2025 Update

    Phase 2 works are well underway and include sewer piping replacement on the pump station property, the addition of an electrical building and an emergency backup generator. Beach Access will continue to be restricted during this time due to construction hazards.

    Phase 2 works will continue until the Spring of 2026.

    Phase 2 works are well underway and include sewer piping replacement on the pump station property, the addition of an electrical building and an emergency backup generator. Beach Access will continue to be restricted during this time due to construction hazards.

    Phase 2 works will continue until the Spring of 2026.

  • April 30, 2025 Update

    Phase 1 of the upgrade project has been mostly completed. The first phase focused on foreshore works necessary to facilitate bypass pumping and improving wetwell access for RDN staff. The next phase of the project will begin early May 2025 and includes the addition of a new electrical building, emergency backup generator, odour control unit, and replacement of large diameter sewer piping from the station up to the intersection of Fillinger Crescent and Entwhistle Drive. Significant rock breaking (jack hammering) is not expected to occur during phase 2 and 3 of the project. Thank you for your patience while construction continues.

    Phase 1 of the upgrade project has been mostly completed. The first phase focused on foreshore works necessary to facilitate bypass pumping and improving wetwell access for RDN staff. The next phase of the project will begin early May 2025 and includes the addition of a new electrical building, emergency backup generator, odour control unit, and replacement of large diameter sewer piping from the station up to the intersection of Fillinger Crescent and Entwhistle Drive. Significant rock breaking (jack hammering) is not expected to occur during phase 2 and 3 of the project. Thank you for your patience while construction continues.

Page last updated: 10 Nov 2026, 03:22 PM
