Share Well Drilling Update - December 2025 on Facebook
Share Well Drilling Update - December 2025 on Linkedin
Email Well Drilling Update - December 2025 link
Thank you for your cooperation over the summer and fall months while we completed the well drilling and testing phase of the project.
Work Completed

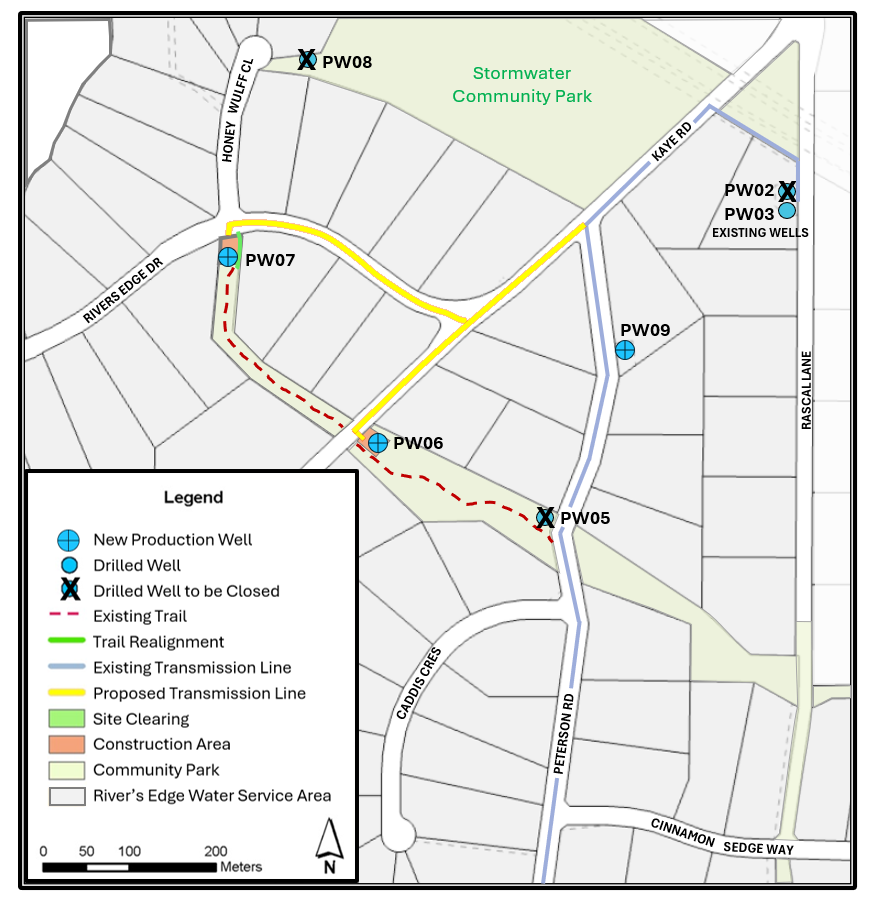

The Regional District of Nanaimo (RDN) has completed the well drilling, development, pump testing and water quality testing of five new wells. This includes PW09, an extra well drilled in addition to the four initial wells planned in this project. The well locations are shown on the map below.
The long-term continuous and sustainable pumping rates (safe yields) at low ground water level conditions and the safe yields at intermittent or high groundwater conditions are given in the table below.
Well # |
Well Location |
Safe pump yield at low groundwater level conditions (i.e. summer)(USGPM) |
Safe pump yield at high groundwater level conditions (i.e. winter) (USGPM) |
PW05 |
2325 Peterson Rd |
4 |
8 |
PW06 |
2300 Kaye Rd |
35 |
48 |
PW07 |
880 River’s Edge Dr |
8 |
17 |
PW08 |
Stormwater Community Park |
N/A |
N/A |
PW09 |
2260 Peterson Rd |
30 |
55 |
Well # PW08, located in the Stormwater Community Park near Honey Wulff Close, was pump tested at 7.5 USGPM. Although the well was able to sustainably produce water, the aquifer at this location was found to have a significant hydraulic connection between the lower and middle aquifer. Since this project is intended to minimize chloride intrusion from the lower aquifer into the middle aquifer, and pumping this well (PW08) would be counterproductive to that objective, it was decided not to bring PW08 into operation.
Chloride concentrations in all of the RDN’s River’s Edge production wells were checked at different pumping durations to gain an in-depth understanding of the hydraulic connections between the middle aquifer and lower aquifer at each well location, and to determine whether short vs. long pumping durations would trigger a significant rise in chloride levels. A summary of chloride concentrations is given in the table below.

* The taste threshold for chloride in drinking water is 250 mg/L, for plant health it’s 100 mg/L, and the indicator of saltwater intrusion potential is 150 mg/L.
Next Steps
The Project Hydrogeologist is currently analyzing the data to determine whether connecting each new well to the River’s Edge water system will meet the overall project objective of minimizing chloride intrusion. He will also recommend a safe, sustainable operating schedule for the wells. The final hydrogeological report will be completed in March 2026 and the RDN will include this report in an application to Island Health for source approval of the new wells. Once the source approval has been received, the RDN will issue a competitive tender for construction of the watermains, power, and control works that would bring the new wells into operation. While waiting for the source approval, the RDN has retained MPE Engineering to undertake the survey, design work, tender specifications, and permit applications. MPE will also provide construction supervision once construction begins.
Anticipated Project Timeline
- Surveying and pump design – December 2025 to February 2026
- Completion of hydrogeological analyses and reporting – February/March 2026
- Completion of design and tender specifications for watermains and power/control infrastructure – March/April 2026
- Confirmation of Island Health source approval – April/May 2026
- Construction permits received from Island Health and Ministry of Transportation and Transit – May 2026
- Tender invitation – May/June 2026
- Construction begins – August 2026
- Construction is complete – March 2027
- Property owners indicate their intended debt repayment option to RDN (as one lump sum or tax amortization of project costs) – June/July 2027
- Project is closed – September 2027
Share Well Drilling Update - September 2025 on Facebook
Share Well Drilling Update - September 2025 on Linkedin
Email Well Drilling Update - September 2025 link
Thank you for your cooperation over the summer months during the well drilling and testing.
Work Completed
The Regional District of Nanaimo (RDN) completed the well drilling and well screen development of four new groundwater wells at the locations shown in the map image below. Twenty-four-hour pumping tests of PW06 and PW07 were completed in early September 2025, and the twenty-four-hour pumping tests of the other two wells, PW05 and PW08 will be completed by mid-September 2025. The long-term continuous and sustainable pumping test rate (safe yield) from each well will be determined after the completion of all the pumping tests. Based on the safe yield from each well, an appropriate well pump and motor will be ordered and installed.
The preliminary analyses, based on the completed twenty-four-hour pumping tests of PW06 and PW07 and the short pumping tests of PW05 and PW08, show that the safe yield of PW06 would be approximately 30 United States Gallons Per Minute (USGPM) and the other three wells would be approximately 5 USGPM each. Since the RDN's initial plan was to withdraw a total of 60 USGPM from these new wells, this leaves a shortfall of approximately 10-15 USGPM production rate. To accommodate this shortfall, an additional well will be drilled, PW09.

Next Steps
PW09 will be drilled at one of the RDN's existing well sites, PW01, near 2260 Peterson Road (see photo below). The existing wells at this site were completed in the lower aquifer and they are only being used for monitoring purposes. The new well at this site will be completed in the middle aquifer layer where the good drinking water source is located. Considering there is already a transmission main installed at this site which could be connected to the new well, and the RDN has a utility right-of-way at this site requiring almost no additional site preparation for the new well, PW09 can be drilled and brought into operation within the existing budget. Additionally, having PW09 drilled as part of the ongoing drilling project reduces the contractor's mobilization and demobilization costs allowing the drilling, development and pumping tests to be completed at the competitive tender rate obtained for the other four wells. The drilling, development and pumping test of PW09 is planned to be completed by October 31, 2025.

The RDN is also in the process of retaining an engineering consultant to provide survey, design and construction supervision for the civil, structural, mechanical, electrical, instrumentation and control/automation aspect of the transmission mains and well site infrastructure for all of the wells completed in this project. The construction of this phase is tentatively planned to begin in the summer of 2026.
Share Well Drilling to Begin June 30, 2025 on Facebook
Share Well Drilling to Begin June 30, 2025 on Linkedin
Email Well Drilling to Begin June 30, 2025 link
Date: June 30 to September 30, 2025
Time: 8 a.m. to 4:30 p.m.

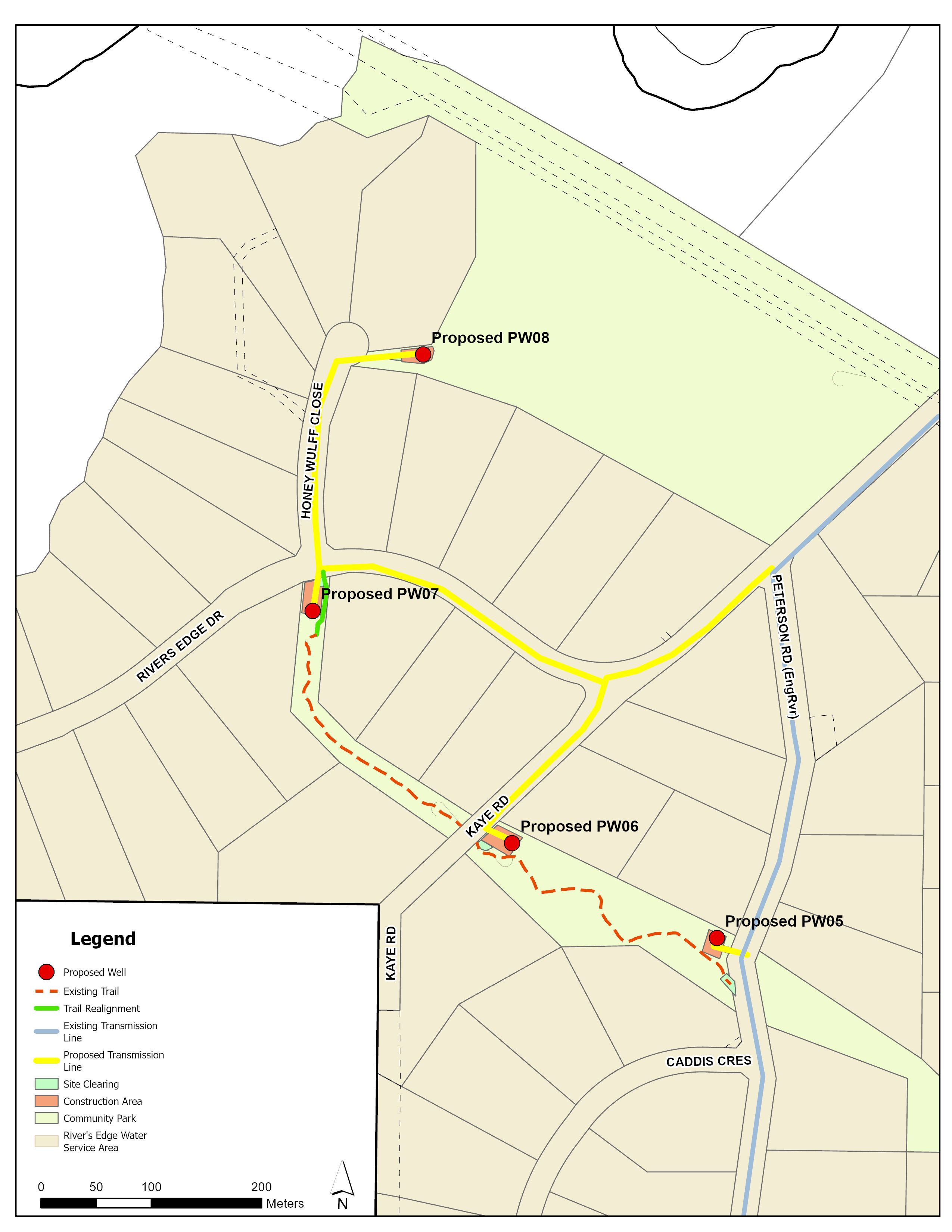

Well drilling will begin on June 30, 2025 at the PW05 Peterson Road site (please see the map below for well drilling sites). One well is expected to be drilled at each of the four prospective well sites between June 30 and September 30, 2025.
